Data center campus
Meta Hyperion Data Center (Richland Parish)
Meta Hyperion Data Center is an AI data center campus developed by Meta Platforms in Louisiana, Delhi. 5 GW of capacity has been announced; none is energized yet. The gap is what this page tracks: what is claimed versus what is actually built, each figure dated and sourced.
Under construction · Meta Platforms · Private land · MISO · Delhi, Louisiana, United States
Capacity: announced vs energized
Announced-to-energized gap: 5 GW. Every figure below is a single dated, sourced claim. Current best per series resolves by evidence tier, then date. See the methodology.
Promised online: Q4 2027. 15 months away. Claimed by Meta (source).
| Source | ||||
|---|---|---|---|---|
| Announced | 5 GW | 2026-07-13 | claimed | press release |
| Energized | 0 GW | 2026-08-17 | reported | journalist report |
| Under construction | 2 GW | 2026-07-13 | claimed | journalist report |
Construction evidence

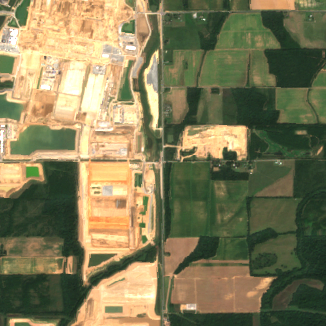

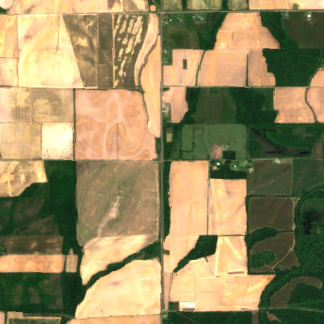

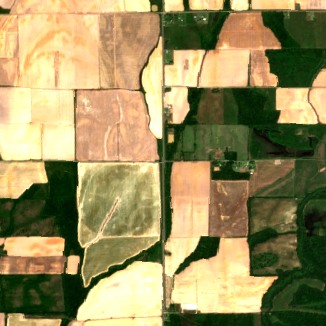

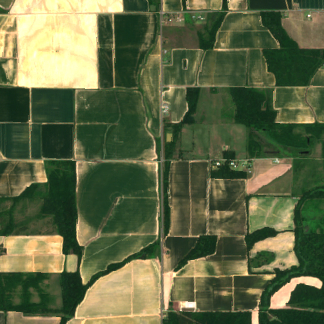

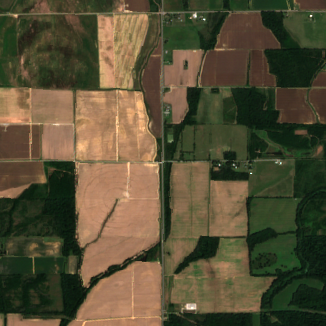

Dated satellite imagery of the site itself, oldest to newest, with the campus milestones that landed in each window. This is what the site looked like from orbit while announcements, permits, and energizations were dated into our ledger, so bare land, grading, and building mass tell their own story alongside the paper trail. Sentinel-2 true color, 10 m resolution, cloud-free scenes; click any frame to expand it.
Delivery paceAnnounced Q3 2026 · live Q3 2026 · 1 mo build
Dated Sentinel-2 imagery, gated to hand-verified site coordinates. Milestones synthesized from the campus's own capacity ledger, financial claims, and lifecycle events; each chip links to its source. How we source and verify it: satellite construction evidence.
Per-building manifest tied to the site polygons and imagery. When we know a building's outline we render it; when we know only its year and capacity we still surface those as first-class rows so the campus total is auditable, not a headline claim. Sorted largest-first; 2 on record.
Manifest totals: 1,011,378 sqft. Rolled from the per-building rows above.
Key facts
Lifecycle
Announced
Energized
Developer
Location
Grid
Land
Announced-to-energized gap
Reported facts
Structured facts sourced from citations already on this record. Each fact traces to a source in the References section below.
- Hyperion bond ~94.4¢ (reported, Sep 2026)
- Reported (Protos; secondary X @akburtonto, Sep 23 2026): the ~$27.3B bond package financing Meta's Hyperion AI data center (issued via Beignet Investor LLC) reportedly traded near ~94.4 cents on the dollar, described as a record low since the deal priced at par. Soft secondary-market figures from secondary coverage; not confirmed by Meta IR or a wire primary
On the data center map
Every tracked data center is on this map, centered on Meta Hyperion Data Center. Pan or zoom out to see how close rivals are building.
- Announced capex
- $50B
- Jobs
- 1,000 permanent reported
- Grid
- MISO · Grid connected, utility build under way: Entergy Louisiana is building several new transmission facilities to serve the campus and has already broken ground on a key substation. Louisiana's public service commission approved the agreement on 20 August 2025. Entergy's own announcement does not break out line lengths, substation counts or costs.
- Tenant
- Meta Platforms
- Cost per MW
- $10M/MW
- Cost per job
- $50M per permanent job
Every figure is one row in the ledger below with its source. Derived rows are pure arithmetic on the rows above (not new claims). Absent lines mean the fact isn't on record yet.
In clusterLouisiana(25)
The deal
- financier
- Blue Owl Capital · 80% of the $27B JV that finances/builds/operates the physical campus.
- utility
- Entergy Louisiana · Building the gas generation fleet (10 plants / ~7.5 GW) to serve the load.
- grid operator
- MISO · Entergy Louisiana operates within MISO.
- developer
- Meta Platforms · 20% owner of build JV; owner-operator of the compute.
- tenant
- Meta Platforms · Self-tenant; AI/superintelligence compute.
Power
- Power source
- mixed
- Grid operator
- MISO
- Interconnection
- Grid connected, utility build under way: Entergy Louisiana is building several new transmission facilities to serve the campus and has already broken ground on a key substation. Louisiana's public service commission approved the agreement on 20 August 2025. Entergy's own announcement does not break out line lengths, substation counts or costs.
- Water
- Operator describes a closed-loop system circulating a glycol mixture through the data halls, with heat rejected via dry cooling for the majority of the year; a water permit is reported at roughly 23 MGD across six wells sized to peak-summer demand.
Entergy Louisiana new gas plants (first three), 2.26 GW gas, Permitted. First three CCGT plants approved by the Louisiana PSC in 2025 to serve Hyperion.
Entergy Louisiana additional gas plants (seven more), 5.30 GW gas, Announced. Seven additional plants (~5.3 GW) sought; brings total to 10 plants / ~7.5 GW. LPSC approval pending.
Meta-funded clean/renewable generation + battery storage, 2.50 GW solar storage, Announced. Meta commits to fund up to 2.5 GW of clean and renewable energy including battery storage; also nuclear uprates.
The MISO grid demand right now: 82.0 GW (EIA-930, 2026-09-27 21:00). Meta Hyperion Data Center's announced 5 GW would be 6.1% of the grid's current load.
County water status: Moderate drought (D1) in Richland Parish, week of 2026-09-22 (US Drought Monitor). Data centers are large water users for cooling; this is the neutral local water picture.
Silicon on site
Every AI chip publicly attributed to Meta Hyperion Data Center (Richland Parish) on the DEPLOY registry. Quantity hints are unstructured because underlying disclosures vary by an order of magnitude. Source links per row.
- as of 2024-04-10
Meta's own AI accelerator generation deployed at Hyperion
reported - as of 2024-03-12
Nvidia complement to MTIA for training + inference at Hyperion
reported
Why here
Meta Hyperion Data Center sits on private land in Louisiana, Delhi. It connects to the MISO grid, draws on mixed power, interconnection is Grid connected, utility build under way: Entergy Louisiana is building several new transmission facilities to serve the campus and has already broken ground on a key substation. Louisiana's public service commission approved the agreement on 20 August 2025. Entergy's own announcement does not break out line lengths, substation counts or costs.. This siting summary is composed from the record's held fields, not speculation; see methodology.
Financial structure
- Total Meta investment in Richland Parish
- $50B. Nearly 10 million sq ft campus; up from $10B originally announced Dec 2024. journalist report
- Blue Owl Capital JV (Meta 20% / Blue Owl 80%)
- up to $27B. Oct 2025 JV to finance, build and operate the campus; up to $27B total development cost. journalist report
Regulatory paper trail
The filings and rules on record for this site and its jurisdiction, most recent first. Each is a sourced, dated artifact you can follow to the primary document.
Investment, workforce and specs
Timeline
- Aug 2026capacity changedenergized: unknown to 0
- Sep 2026Current: Under construction
Sources
- Deepening our investment in Richland Parish, Louisiana · Meta Data Centers
- Meta's Louisiana data center investment to reach $50 billion · CNBC
- Meta orders 10 gas-fired power plants for its Hyperion AI campus · Fortune
- Entergy Louisiana Says 7 More Gas Plants Necessary for Meta Data Center · RTO Insider
- Richland Parish Data Center · Meta
- Entergy to build $1.2bn 500kV transmission line to serve Meta mega data center in Louisiana · Data Center Dynamics
- Entergy Louisiana receives LPSC approval for major infrastructure investments to support Meta's data center · Entergy
- Meta's AI bond just hit a record low as its stock soared · Protos
- Meta Hyperion ~$27.3B bonds reportedly ~94.4¢ (secondary X) · X (@akburtonto)
89efdd2f-1ec9-47a1-bb7c-a1ad597bc991 · Tracked with DEPLOY's verified-vs-claimed methodology. Every term is defined in the glossary. Announced numbers are claims, not built capacity.
Head-to-head
Common questions
What is Meta Hyperion Data Center (Richland Parish)?
How much power will Meta Hyperion Data Center (Richland Parish) use?
Who is building Meta Hyperion Data Center (Richland Parish)?
Is Meta Hyperion Data Center (Richland Parish) operating yet?
How verified is the data on Meta Hyperion Data Center (Richland Parish)?
Deploy Watch
Track Meta Hyperion Data Center (Richland Parish) on Deploy.
We notify you when energized capacity, lifecycle state, or a new dated capacity claim changes against primary-source evidence, not when the developer issues a press release.
Cite this page
DEPLOY. (2026). Meta Hyperion Data Center (Richland Parish): AI data center campus record. Retrieved September 27, 2026, from https://registry.deploy.report/datacenters/meta-hyperion-louisiana
More citation formats (MLA, Chicago, BibTeX) →The verified data on this page is available under a Creative Commons Attribution 4.0 license: reuse the facts freely, with attribution to DEPLOY (deploy.report). The prose, design, and any imagery are not included and keep their own rights.
Machine-readable surfaces
- Markdown mirror: /datacenters/meta-hyperion-louisiana.md
- JSON-LD: embedded in this page’s head
- REST API: /v1/datacenters/meta-hyperion-louisiana
- Data documentation: /data
- Query this programmatically: Deploy MCP
