Data center campus

Fermi America HyperGrid (Project Matador)

Fermi America HyperGrid is an AI data center campus developed by Fermi America (Fermi Inc) in Texas, Amarillo. 11 GW of capacity has been announced; none is energized yet. The gap is what this page tracks: what is claimed versus what is actually built, each figure dated and sourced.

Under construction · Fermi America (Fermi Inc) · Private land · SPP · Amarillo, Texas, United States


Capacity: announced vs energized

Announced-to-energized gap: 11 GW. Every figure below is a single dated, sourced claim. Current best per series resolves by evidence tier, then date. See the methodology.

Promised online: Q4 2026. 3 months away. Claimed by Fermi America (Rick Perry / company statements) (source).

Fermi America HyperGrid (Project Matador) capacity claims
Source
Announced11 GW2025-06-26claimedpress release
Energized0 GW2026-08-17reportedjournalist report
Under construction2.30 GW2026-01-01claimedpress release

Construction evidence

Dated satellite imagery of the site itself, oldest to newest, with the campus milestones that landed in each window. This is what the site looked like from orbit while announcements, permits, and energizations were dated into our ledger, so bare land, grading, and building mass tell their own story alongside the paper trail. Sentinel-2 true color, 10 m resolution, cloud-free scenes; click any frame to expand it.

Delivery paceAnnounced Q2 2025 · live Q3 2026 · 1 yr 2 mo build

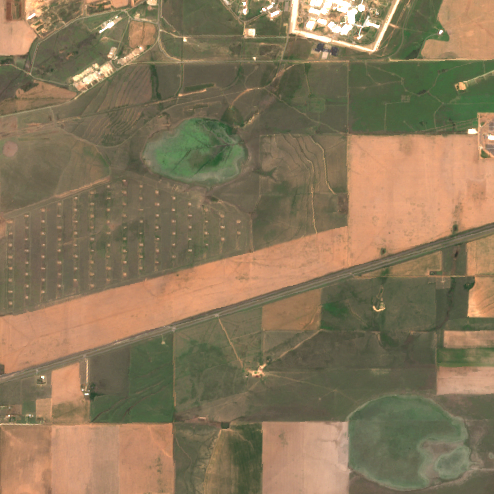

2018-08-04Contains modified Copernicus Sentinel data 2018

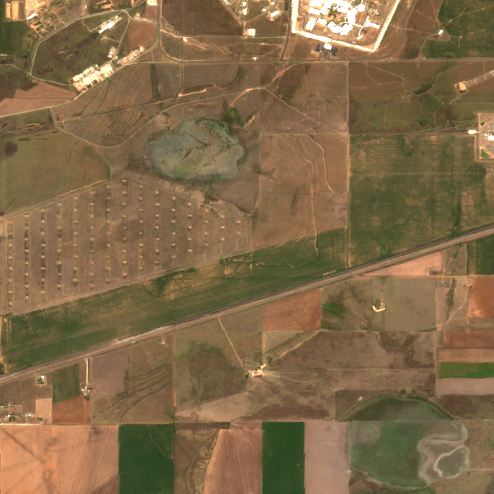

2020-08-28Contains modified Copernicus Sentinel data 2020

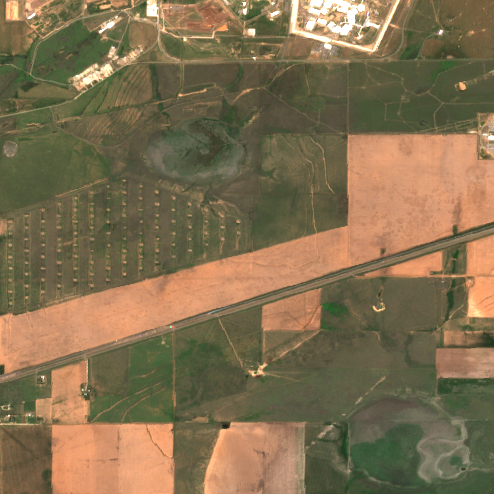

2022-09-02Contains modified Copernicus Sentinel data 2022

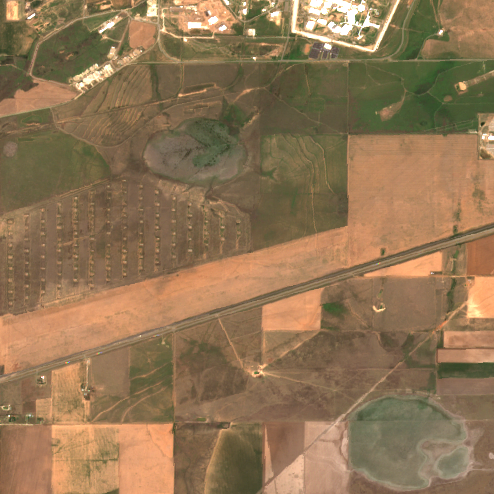

2024-08-17Contains modified Copernicus Sentinel data 2024

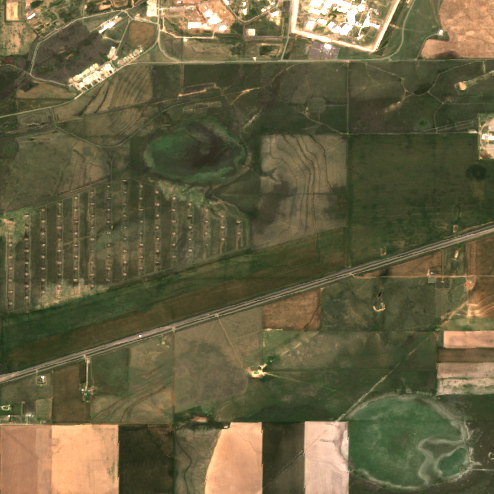

2025-05-16Contains modified Copernicus Sentinel data 2025

Dated Sentinel-2 imagery, gated to hand-verified site coordinates. Milestones synthesized from the campus's own capacity ledger, financial claims, and lifecycle events; each chip links to its source. How we source and verify it: satellite construction evidence.

Key facts

11 GW

Announced

0 GW

Energized

Fermi America (Fermi Inc)

Developer

SPP

Grid

11 GW

Announced-to-energized gap

On the data center map

Every tracked data center is on this map, centered on Fermi America HyperGrid. Pan or zoom out to see how close rivals are building.

Free to use on your site, with a link back to DEPLOY.
The story of Fermi America HyperGrid (Project Matador)
Announced capex
$1.4B
Water
2.5M gal/day (10K households)
Cooling
Hybrid dry and wet cooling towers, claimed to lose more than 80 percent less to evaporation than conventional all-wet towers
Grid
SPP · No interconnection queue position: the campus is built behind the meter, generating its own power on site rather than waiting for a grid connection. The Panhandle location sits in Southwest Power Pool territory served by Xcel, not ERCOT.
Derived
Cost per MW
$127K/MW

Every figure is one row in the ledger below with its source. Derived rows are pure arithmetic on the rows above (not new claims). Absent lines mean the fact isn't on record yet.

In clusterTexas(607)

The deal

developer
Fermi America (Fermi Inc) · Developer/owner; co-founded by former US Energy Secretary Rick Perry. Publicly traded on Nasdaq.
developer
Texas Tech University System · Partner in the HyperGrid campus.
financier
Keystone National Group / Cape Commercial Finance · $200M equipment financing facility.
grid operator
SPP · Amarillo/Texas Panhandle sits in SPP territory; however the campus is designed behind-the-meter on a private grid, cutting out utilities.

Power

Power source
mixed
Grid operator
SPP
Interconnection
No interconnection queue position: the campus is built behind the meter, generating its own power on site rather than waiting for a grid connection. The Panhandle location sits in Southwest Power Pool territory served by Xcel, not ERCOT.
Water
Municipal water off the Ogallala. Amarillo agreed to sell the campus 2.5 million gallons a day on a 20 year contract with two 10 year renewal options, at twice the rate a commercial user inside the city pays, and Fermi covers the cost of the two new Carson County wells the city needs to supply it. Fermi's own filing puts its expected need at up to 5.5 million gallons a day, and the city expects it back asking for that. Use is metered, but neither the water agreement nor the tax abatement says what happens if Fermi exceeds it.

Advanced nuclear reactors (four ~1 GW units), 4 GW nuclear, Permitted. NRC reviewing applications for four 1-GW reactors per external reporting; unbuilt. Largest nuclear component of the campus.

Combined-cycle natural gas plant, gas, Under construction. Described as the nation's biggest combined-cycle gas project; anchors near-term power (first 1 GW by late 2026).

Solar + battery energy storage (BESS), solar storage, Announced. Solar, wind and BESS integrated into behind-the-meter HyperGrid; capacities not itemized.

The SPP grid demand right now: 28.9 GW (EIA-930, 2026-09-27 07:00). Fermi America HyperGrid's announced 11 GW would be 38.0% of the grid's current load.

County water status: Exceptional drought (D4) in Carson County, week of 2026-09-22 (US Drought Monitor). Data centers are large water users for cooling; this is the neutral local water picture.

Silicon on site

Every AI chip publicly attributed to Fermi America HyperGrid (Project Matador) on the DEPLOY registry. Quantity hints are unstructured because underlying disclosures vary by an order of magnitude. Source links per row.

  1. Planned Blackwell capacity for the Fermi HyperGrid campus (2 GW target, four planned SMRs)

    reported

    Fermi America

Why here

Fermi America HyperGrid sits on private land in Texas, Amarillo. It connects to the SPP grid, draws on mixed power, interconnection is No interconnection queue position: the campus is built behind the meter, generating its own power on site rather than waiting for a grid connection. The Panhandle location sits in Southwest Power Pool territory served by Xcel, not ERCOT.. This siting summary is composed from the record's held fields, not speculation; see methodology.

Financial structure

Site buildout invested to date
$1.4B press release
Keystone/Cape equipment facility
up to $200M. Equipment financing facility from Keystone National Group and Cape Commercial Finance to accelerate first 2.3 GW press release
Nasdaq IPO proceeds
$683M sec filing

Regulatory paper trail

The filings and rules on record for this site and its jurisdiction, most recent first. Each is a sourced, dated artifact you can follow to the primary document.

NHTSA Recall: Zoox Robotaxi Software Update for Heavy Smoke Visibility (26E044)operational restriction · 2026-07-15 · United States

Investment, workforce and specs

Cooling
Hybrid dry and wet cooling towers, claimed to lose more than 80 percent less to evaporation than conventional all-wet towers source
Water (gal/day)
2,500,000 source

Timeline

  1. Aug 2026
    claim recorded
    metric:cooling_type
  2. Sep 2026
    Current: Under construction

Sources

10010870-fc71-428e-b78e-66f972d37c33 · Tracked with DEPLOY's verified-vs-claimed methodology. Every term is defined in the glossary. Announced numbers are claims, not built capacity.

Head-to-head

Common questions

What is Fermi America HyperGrid (Project Matador)?
Fermi America HyperGrid (Project Matador) is an AI data center campus tracked on the DEPLOY registry, located in Amarillo. DEPLOY records its capacity as a dated, sourced ledger: announced gigawatts versus actually energized gigawatts, never a press-release total.
How much power will Fermi America HyperGrid (Project Matador) use?
Fermi America HyperGrid (Project Matador) has 11 GW of announced capacity on the DEPLOY registry, of which 0 GW is recorded as energized, an announced-to-energized gap of 11 GW. Each figure is individually dated and sourced.
Who is building Fermi America HyperGrid (Project Matador)?
Fermi America (Fermi Inc) is recorded as a party to Fermi America HyperGrid (Project Matador) on the DEPLOY registry.
Is Fermi America HyperGrid (Project Matador) operating yet?
As of the most recent verification on the DEPLOY registry, Fermi America HyperGrid (Project Matador) is under construction. DEPLOY tracks the lifecycle from announced through energized, so the current state reflects sourced evidence, not the original announcement.
How verified is the data on Fermi America HyperGrid (Project Matador)?
A human editor has reviewed this record for the indexed registry. Every capacity figure is an append-only, dated claim resolved to the highest-evidence tier; superseded claims are kept but excluded from the current view.

Deploy Watch

Track Fermi America HyperGrid (Project Matador) on Deploy.

We notify you when energized capacity, lifecycle state, or a new dated capacity claim changes against primary-source evidence, not when the developer issues a press release.

Cite this page

DEPLOY. (2026). Fermi America HyperGrid (Project Matador): AI data center campus record. Retrieved September 27, 2026, from https://registry.deploy.report/datacenters/fermi-amarillo-texas
