Amazon Project Rainier Data Center (New Carlisle)
Amazon Project Rainier Data Center is an AI data center campus developed by Amazon in Indiana, New Carlisle. 2.20 GW of capacity has been announced; 0.91 GW is energized. The gap is what this page tracks: what is claimed versus what is actually built, each figure dated and sourced.
Partially energized · Amazon · Private land · PJM · New Carlisle, Indiana, United States
Capacity: announced vs energized
Announced-to-energized gap: 1.29 GW. Every figure below is a single dated, sourced claim. Current best per series resolves by evidence tier, then date. See the methodology.
Promised online: 2025. Energized capacity is now on record. Claimed by Amazon / AWS (source).
| Source | ||||
|---|---|---|---|---|
| Announced | 2.20 GW | 2025-10-29 | claimed | journalist report |
| Energized | 0.91 GW | 2026-03-23 | reported | journalist report |
| Under construction | 1.93 GW | 2028-01-01 | claimed | journalist report |
Construction evidence

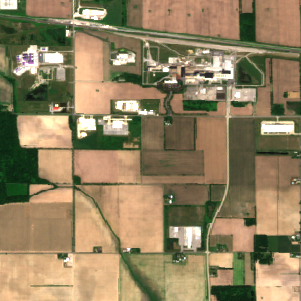

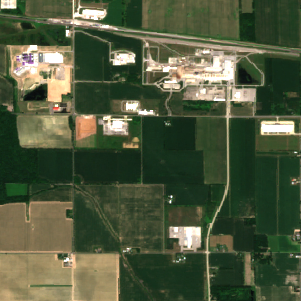

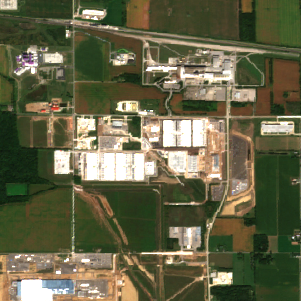

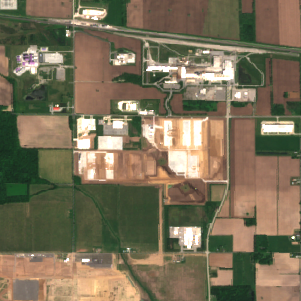

Dated satellite imagery of the site itself, oldest to newest, with the campus milestones that landed in each window. This is what the site looked like from orbit while announcements, permits, and energizations were dated into our ledger, so bare land, grading, and building mass tell their own story alongside the paper trail. Sentinel-2 true color, 10 m resolution, cloud-free scenes; click any frame to expand it.
Delivery paceAnnounced Q4 2025 · live Q1 2026 · 5 mo build
Dated Sentinel-2 imagery, gated to hand-verified site coordinates. Milestones synthesized from the campus's own capacity ledger, financial claims, and lifecycle events; each chip links to its source. How we source and verify it: satellite construction evidence.
Per-building manifest tied to the site polygons and imagery. When we know a building's outline we render it; when we know only its year and capacity we still surface those as first-class rows so the campus total is auditable, not a headline claim. Sorted largest-first; top 6 shown by default of 12.
Manifest totals: 3,515,749 sqft. Rolled from the per-building rows above.
Key facts
Lifecycle
Announced
Energized
Developer
Location
Grid
Land
Announced-to-energized gap
On the data center map
Every tracked data center is on this map, centered on Amazon Project Rainier Data Center. Pan or zoom out to see how close rivals are building.
- Announced capex
- $11B
- Grid
- PJM · Grid connected, utility build in progress: AEP is building two new 345 kV delivery substations, Larrison Drive and New Prairie, plus fault-duty upgrades at the existing Olive station, a transmission package of about $185 million targeting roughly 1.1 GW of service by December 2026. Indiana Michigan Power holds a separate authorisation of about $68 million for its own New Carlisle 345 kV station. Full build-out is planned at 2.2 GW.
- GPUs
- 500K 500,000 Trainium2
- Tenant
- Anthropic
- AI here
- Claude (Anthropic)
- Cost per MW
- $5M/MW
Every figure is one row in the ledger below with its source. Derived rows are pure arithmetic on the rows above (not new claims). Absent lines mean the fact isn't on record yet.
In clusterIndiana(86)
The deal
- utility
- Indiana Michigan Power (AEP) · Grid supply and high-voltage interconnection.
- grid operator
- PJM · I&M operates within PJM Interconnection.
- tenant
- Anthropic · Primary tenant; trains and serves Claude models on the cluster.
- developer
- Amazon · Owner-operator of the ~1,200-acre New Carlisle campus.
- chip supplier
- Amazon · Amazon's in-house AI accelerators; ~500k Trainium2 chips deployed.
- investor
- Amazon · Strategic investor in Anthropic in addition to infrastructure provider.
Power
- Power source
- grid
- Grid operator
- PJM
- Interconnection
- Grid connected, utility build in progress: AEP is building two new 345 kV delivery substations, Larrison Drive and New Prairie, plus fault-duty upgrades at the existing Olive station, a transmission package of about $185 million targeting roughly 1.1 GW of service by December 2026. Indiana Michigan Power holds a separate authorisation of about $68 million for its own New Carlisle 345 kV station. Full build-out is planned at 2.2 GW.
- Water
- Uses free-air cooling about 90% of the year, switching to evaporative (water) cooling only when ambient temperature exceeds ~85F; cooling water is drawn from the New Carlisle aquifer, with Phase 1 permitted at ~1.6M gal/day and Amazon stating water is used in under 2% of hours annually.
Indiana Michigan Power (AEP) grid supply, 2.20 GW grid ppa, Under construction. I&M (AEP subsidiary) partnered with AWS to deliver high-voltage infrastructure; grid-supplied within PJM.
The PJM grid demand right now: 80.3 GW (EIA-930, 2026-09-27 16:00). Amazon Project Rainier Data Center's announced 2.20 GW would be 2.7% of the grid's current load.
County water status: No drought in Saint Joseph County, week of 2026-09-22 (US Drought Monitor). Data centers are large water users for cooling; this is the neutral local water picture.
Silicon on site
Every AI chip publicly attributed to Amazon Project Rainier Data Center (New Carlisle) on the DEPLOY registry. Quantity hints are unstructured because underlying disclosures vary by an order of magnitude. Source links per row.
- as of 2024-12-03
Anthropic's compute (Project Rainier): hundreds of thousands of Trainium 2 chips
reported
Why here
Amazon Project Rainier Data Center sits on private land in Indiana, New Carlisle. It connects to the PJM grid, draws on grid power, interconnection is Grid connected, utility build in progress: AEP is building two new 345 kV delivery substations, Larrison Drive and New Prairie, plus fault-duty upgrades at the existing Olive station, a transmission package of about $185 million targeting roughly 1.1 GW of service by December 2026. Indiana Michigan Power holds a separate authorisation of about $68 million for its own New Carlisle 345 kV station. Full build-out is planned at 2.2 GW.. This siting summary is composed from the record's held fields, not speculation; see methodology.
Financial structure
- AEP transmission package serving the campus
- $185M. Two new 345 kV delivery substations (Larrison Drive, New Prairie) plus fault-duty upgrades at Olive, targeting about 1.1 GW of service by December 2026. Indiana Michigan Power holds a separate ~$68m authorisation for its own New Carlisle 345 kV station. journalist report
- Amazon Project Rainier investment (announced)
- $11B. Announced at Oct 2025 opening; Epoch estimates ~$34.5B deployed to date, ~$72.9B at full buildout. journalist report
- Anthropic 10-year compute commitment
- $100B. Anthropic to spend >$100B on compute over 10 years and reserve up to 5 GW of Trainium capacity. journalist report
Regulatory paper trail
The filings and rules on record for this site and its jurisdiction, most recent first. Each is a sourced, dated artifact you can follow to the primary document.
Investment, workforce and specs
Estimated compute: the claimed 500,000 Trainium2 chips are on the order of 40x the compute used to train a GPT-4-class model. Derived from the chip-count claim, not measured (basis).
AI models here
- Claude (Anthropic)trained and served source
Reported model-to-campus links, first-party sourced. Companies rarely disclose where a model trains, so this is sparse by nature.
Timeline
- Aug 2026financial recordedtransmission_build: AEP transmission package serving the campus
- Sep 2026Current: Partially energized
Sources
- Amazon opens $11 billion AI data center Project Rainier in Indiana · CNBC
- Anthropic-Amazon New Carlisle | AI Data Centers · Epoch AI
- AWS Project Rainier, Indiana: Latest Updates (2026) · Blackridge Research
- AWS New Carlisle Data Center Campus: Project Rainier · MeasuredAI
- Amazon leader answers questions surrounding incoming New Carlisle data center · WSBT
49044b3a-b534-4134-b8b4-461e0eb98bf2 · Tracked with DEPLOY's verified-vs-claimed methodology. Every term is defined in the glossary. Announced numbers are claims, not built capacity.
Head-to-head
Common questions
What is Amazon Project Rainier Data Center (New Carlisle)?
How much power will Amazon Project Rainier Data Center (New Carlisle) use?
Who is building Amazon Project Rainier Data Center (New Carlisle)?
Is Amazon Project Rainier Data Center (New Carlisle) operating yet?
How verified is the data on Amazon Project Rainier Data Center (New Carlisle)?
Deploy Watch
Track Amazon Project Rainier Data Center (New Carlisle) on Deploy.
We notify you when energized capacity, lifecycle state, or a new dated capacity claim changes against primary-source evidence, not when the developer issues a press release.
Cite this page
DEPLOY. (2026). Amazon Project Rainier Data Center (New Carlisle): AI data center campus record. Retrieved September 27, 2026, from https://registry.deploy.report/datacenters/amazon-project-rainier-indiana
More citation formats (MLA, Chicago, BibTeX) →The verified data on this page is available under a Creative Commons Attribution 4.0 license: reuse the facts freely, with attribution to DEPLOY (deploy.report). The prose, design, and any imagery are not included and keep their own rights.
Machine-readable surfaces
- Markdown mirror: /datacenters/amazon-project-rainier-indiana.md
- JSON-LD: embedded in this page’s head
- REST API: /v1/datacenters/amazon-project-rainier-indiana
- Data documentation: /data
- Query this programmatically: Deploy MCP
