Project Cardinal Data Center Campus — Yorkville

Project Cardinal Data Center Campus — Yorkville is an AI data center campus developed by Pioneer Development, LLC in Illinois, Yorkville. 1.80 GW of capacity has been announced; none is energized yet. The gap is what this page tracks: what is claimed versus what is actually built, each figure dated and sourced.

Permitted · Pioneer Development, LLC · greenfield · PJM · Yorkville, Illinois, United States


Capacity: announced vs energized

Announced-to-energized gap: 1.80 GW. Every figure below is a single dated, sourced claim. Current best per series resolves by evidence tier, then date. See the methodology.

Promised online: 2029. 39 months away. Claimed by Pioneer Development, LLC (source).

Project Cardinal Data Center Campus — Yorkville capacity claims
Source
Announced1.80 GW2026-03-11reportedjournalist report

Construction evidence

Dated satellite imagery of the site itself, oldest to newest, with the campus milestones that landed in each window. This is what the site looked like from orbit while announcements, permits, and energizations were dated into our ledger, so bare land, grading, and building mass tell their own story alongside the paper trail. Sentinel-2 true color, 10 m resolution, cloud-free scenes; click any frame to expand it.

Delivery paceAnnounced Q1 2026 · not yet energized

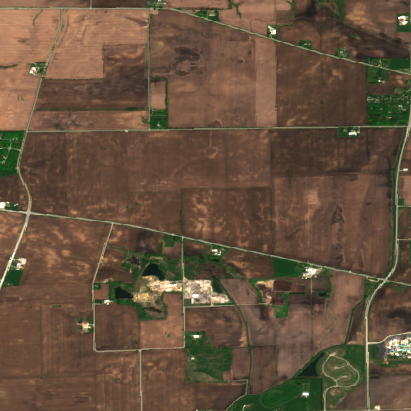

2018-05-16Contains modified Copernicus Sentinel data 2018

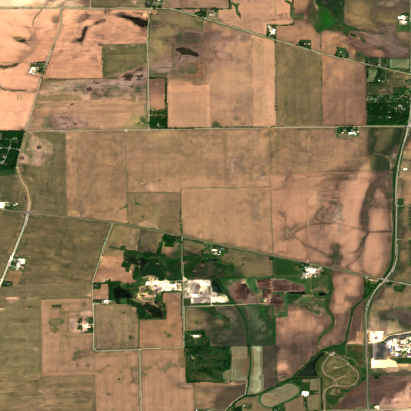

2020-06-14Contains modified Copernicus Sentinel data 2020

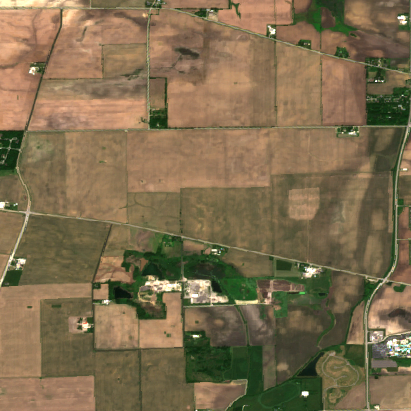

2022-06-14Contains modified Copernicus Sentinel data 2022

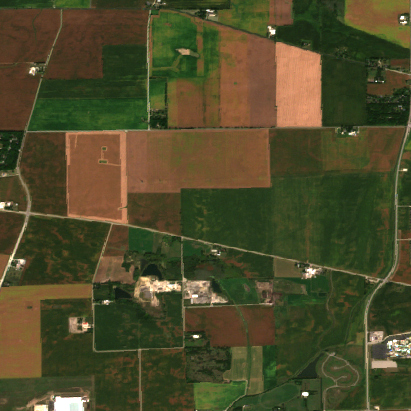

2024-09-11Contains modified Copernicus Sentinel data 2024

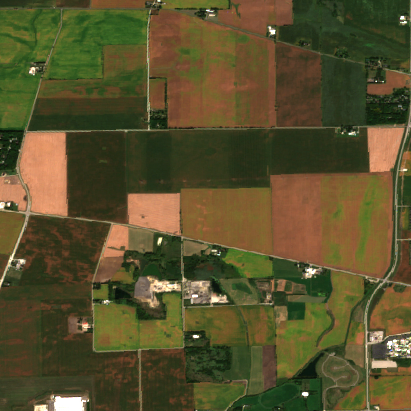

2025-09-16Contains modified Copernicus Sentinel data 2025

Dated Sentinel-2 imagery, gated to hand-verified site coordinates. Milestones synthesized from the campus's own capacity ledger, financial claims, and lifecycle events; each chip links to its source. How we source and verify it: satellite construction evidence.

Key facts

permitted

Lifecycle

1.80 GW

Announced

0 GW

Energized

Pioneer Development, LLC

Developer

PJM

Grid

1.80 GW

Announced-to-energized gap

On the data center map

Every tracked data center is on this map, centered on Project Cardinal Data Center Campus — Yorkville. Pan or zoom out to see how close rivals are building.

Free to use on your site, with a link back to DEPLOY.
The story of Project Cardinal Data Center Campus — Yorkville
Water
170K gal/day (654 households)
Cooling
14 two-story data center buildings, ~17M sq ft total (11 bldgs ~1.9M sq ft each + 3 bldgs ~940,000 sq ft); two on-site substations and a switchyard
Grid
PJM · Waiting on the utility: ComEd had not granted the site a full power allocation as of March 2026, which the council was told must happen before the project can be finalised. Yorkville approved a development agreement on 10 March 2026 carrying a $51 million up-front payment over four years.

Every figure is one row in the ledger below with its source. Derived rows are pure arithmetic on the rows above (not new claims). Absent lines mean the fact isn't on record yet.

In clusterIllinois(168)

The deal

developer
Pioneer Development, LLC · contract purchaser; end user undisclosed
utility
ComEd · full power allocation still pending

Power

Power source
grid
Grid operator
PJM
Interconnection
Waiting on the utility: ComEd had not granted the site a full power allocation as of March 2026, which the council was told must happen before the project can be finalised. Yorkville approved a development agreement on 10 March 2026 carrying a $51 million up-front payment over four years.
Water
Domestic use quantified, cooling makeup water not yet. Burns & McDonnell, the engineer of record, told Yorkville on 5 September 2025 that domestic demand is a draft 0.17 million gallons a day on average with air-cooled chillers, or 0.25 with water-cooled chillers and dry coolers, peaking at 0.31 and 0.44 respectively on a 1.8 peaking factor. Makeup water for the closed-loop system is explicitly undetermined at this stage, depending on end-user design and water quality, and no ongoing irrigation is assumed. Fire flow is estimated at 2,000 gallons per minute minimum at 20 psi.

The PJM grid demand right now: 84.0 GW (EIA-930, 2026-09-27 20:00). Project Cardinal Data Center Campus — Yorkville's announced 1.80 GW would be 2.1% of the grid's current load.

County water status: No drought in Kendall County, week of 2026-09-22 (US Drought Monitor). Data centers are large water users for cooling; this is the neutral local water picture.

Why here

Project Cardinal Data Center Campus — Yorkville sits on greenfield in Illinois, Yorkville. It connects to the PJM grid, draws on grid power, interconnection is Waiting on the utility: ComEd had not granted the site a full power allocation as of March 2026, which the council was told must happen before the project can be finalised. Yorkville approved a development agreement on 10 March 2026 carrying a $51 million up-front payment over four years.. This siting summary is composed from the record's held fields, not speculation; see methodology.

Financial structure

Host-community payment (developer to City of Yorkville)
$51M. $51M upfront commitment from Pioneer Development to the city, paid over four years, per the development agreement approved March 11, 2026 journalist report
Up-front payment to Yorkville under the development agreement
$51M. Paid over four years; agreed 10 March 2026. journalist report

Regulatory paper trail

The filings and rules on record for this site and its jurisdiction, most recent first. Each is a sourced, dated artifact you can follow to the primary document.

NHTSA Recall: Zoox Robotaxi Software Update for Heavy Smoke Visibility (26E044)operational restriction · 2026-07-15 · United States
FCC Proposed Fines Against Drone Companies (July 2026)other · 2026-07-10 · United States
FAA Proposed Rule: Enabling Supersonic Overland Flight (July 2026)operational restriction · 2026-07-02 · United States

Investment, workforce and specs

Cooling
14 two-story data center buildings, ~17M sq ft total (11 bldgs ~1.9M sq ft each + 3 bldgs ~940,000 sq ft); two on-site substations and a switchyard source
Water (gal/day)
170,000 source

Timeline

  1. Aug 2026
    claim recorded
    metric:water_gpd=170000
  2. Sep 2026
    Current: Permitted

Sources

1b2f6d79-9113-487a-aa09-6819682ce056 · Tracked with DEPLOY's verified-vs-claimed methodology. Every term is defined in the glossary. Announced numbers are claims, not built capacity.

Common questions

What is Project Cardinal Data Center Campus — Yorkville?
Project Cardinal Data Center Campus — Yorkville is an AI data center campus tracked on the DEPLOY registry, located in Yorkville. DEPLOY records its capacity as a dated, sourced ledger: announced gigawatts versus actually energized gigawatts, never a press-release total.
How much power will Project Cardinal Data Center Campus — Yorkville use?
Project Cardinal Data Center Campus — Yorkville has 1.80 GW of announced capacity on the DEPLOY registry; no energized capacity is yet recorded. Each figure is individually dated and sourced.
Who is building Project Cardinal Data Center Campus — Yorkville?
Pioneer Development, LLC is recorded as a party to Project Cardinal Data Center Campus — Yorkville on the DEPLOY registry.
Is Project Cardinal Data Center Campus — Yorkville operating yet?
As of the most recent verification on the DEPLOY registry, Project Cardinal Data Center Campus — Yorkville is permitted. DEPLOY tracks the lifecycle from announced through energized, so the current state reflects sourced evidence, not the original announcement.
How verified is the data on Project Cardinal Data Center Campus — Yorkville?
A human editor has reviewed this record for the indexed registry. Every capacity figure is an append-only, dated claim resolved to the highest-evidence tier; superseded claims are kept but excluded from the current view.

Deploy Watch

Track Project Cardinal Data Center Campus — Yorkville on Deploy.

We notify you when energized capacity, lifecycle state, or a new dated capacity claim changes against primary-source evidence, not when the developer issues a press release.

Cite this page

DEPLOY. (2026). Project Cardinal Data Center Campus — Yorkville: AI data center campus record. Retrieved September 27, 2026, from https://registry.deploy.report/datacenters/pioneer-project-cardinal-yorkville-illinois
